Challenge: Cone Drive Contaminated Soil
Solution: Temporary dam and dewatering system
There are environmental cleanups…and then there are environmental cleanups.
To address historic impacts to sediments that resulted from the migration of groundwater contamination to Boardman Lake in the late 1970s, a large remediation effort was performed.
After environmental engineers Global Remediation Technologies (GRT) developed the necessary project scope and complete design documents, GRT, in turn, selected Team Elmer’s to get the job done.
The ambitious project began with the construction and installation of a temporary dam to... Read more
There are environmental cleanups…and then there are environmental cleanups.
To address historic impacts to sediments that resulted from the migration of groundwater contamination to Boardman Lake in the late 1970s, a large remediation effort was performed.
After environmental engineers Global Remediation Technologies (GRT) developed the necessary project scope and complete design documents, GRT, in turn, selected Team Elmer’s to get the job done.

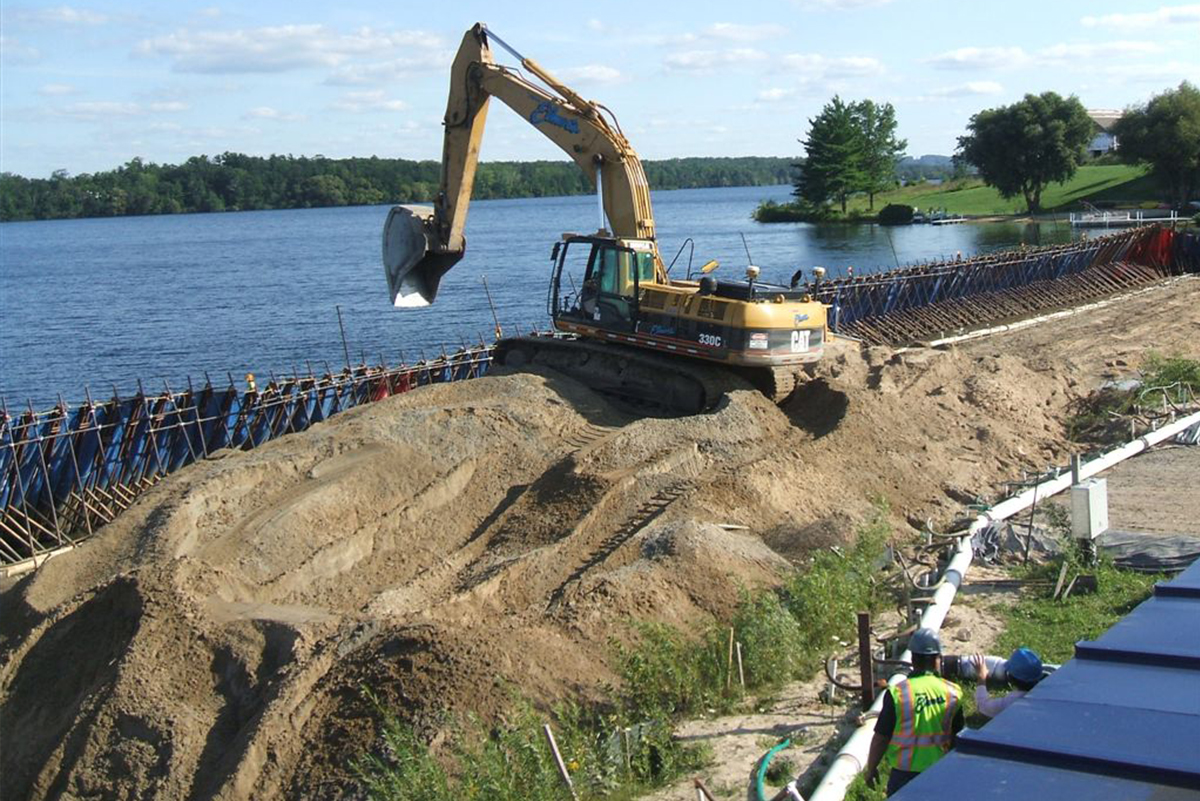

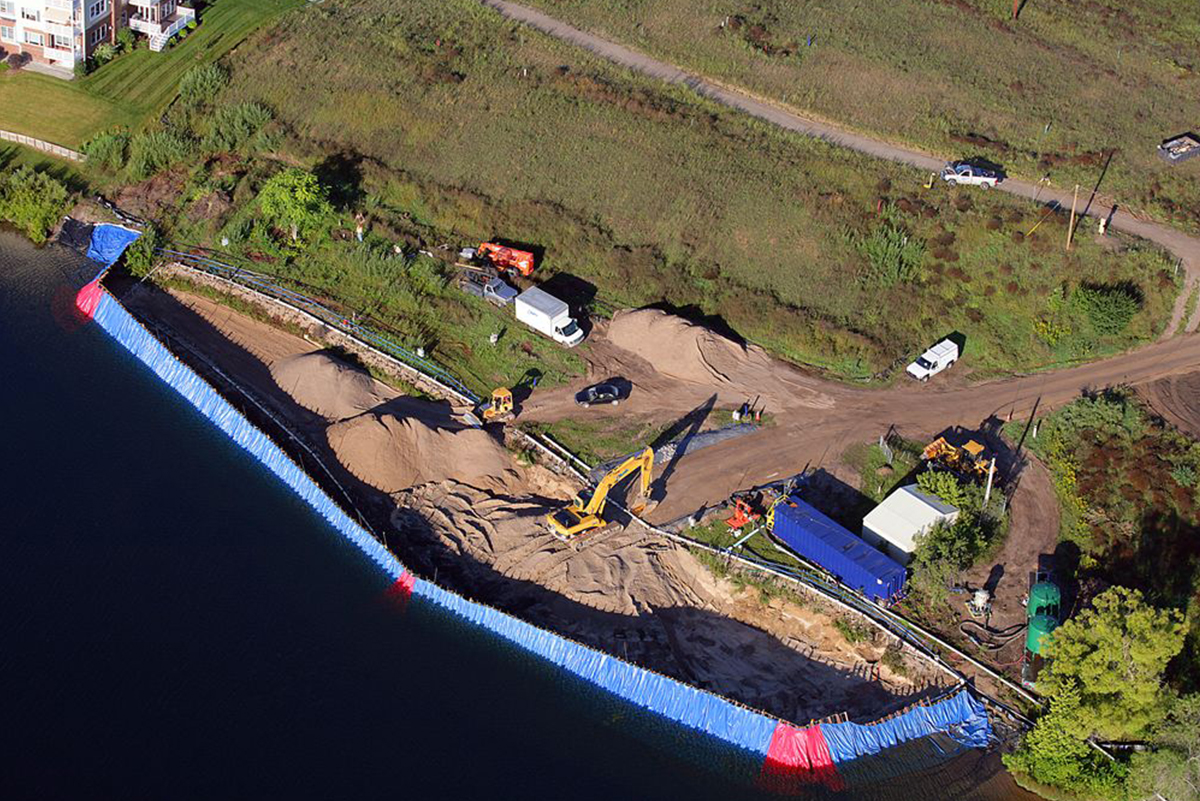

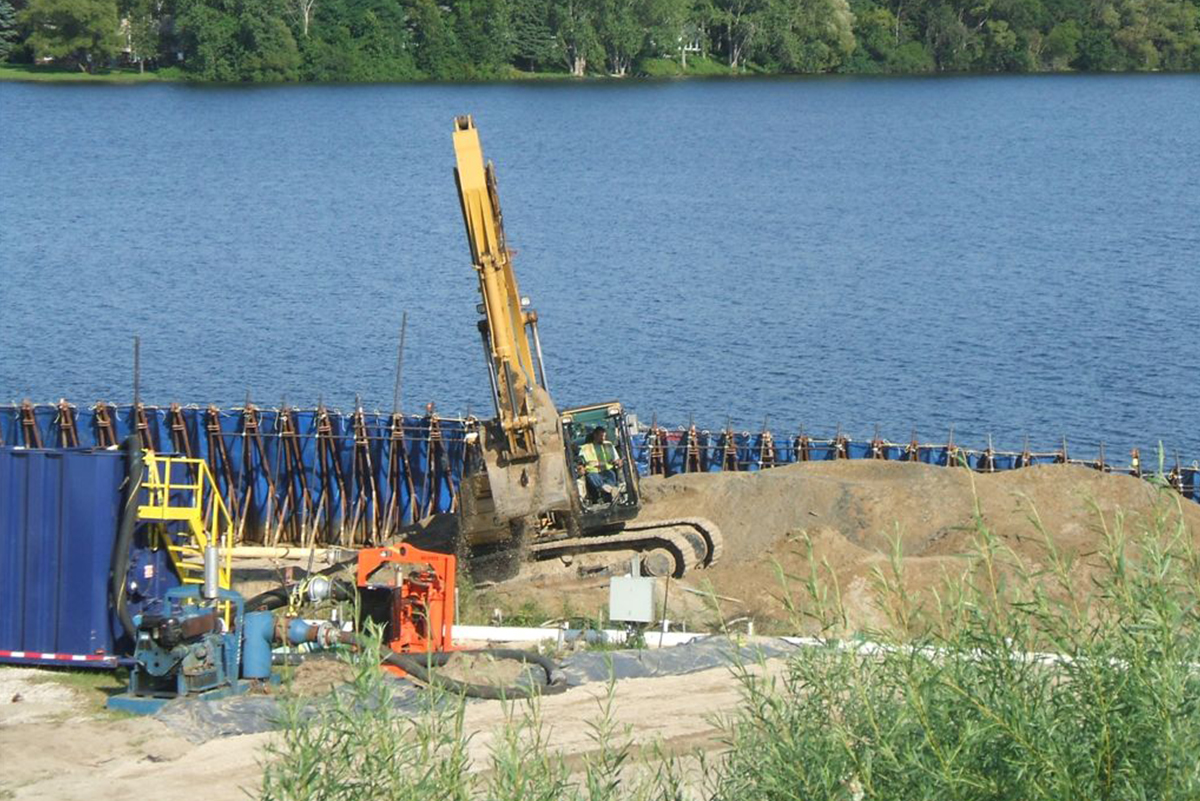

The ambitious project began with the construction and installation of a temporary dam to remove lake water from the contaminated site. And this wasn’t just a wading pool…the dam went 45 feet into the lake and covered 350 feet of shoreline!

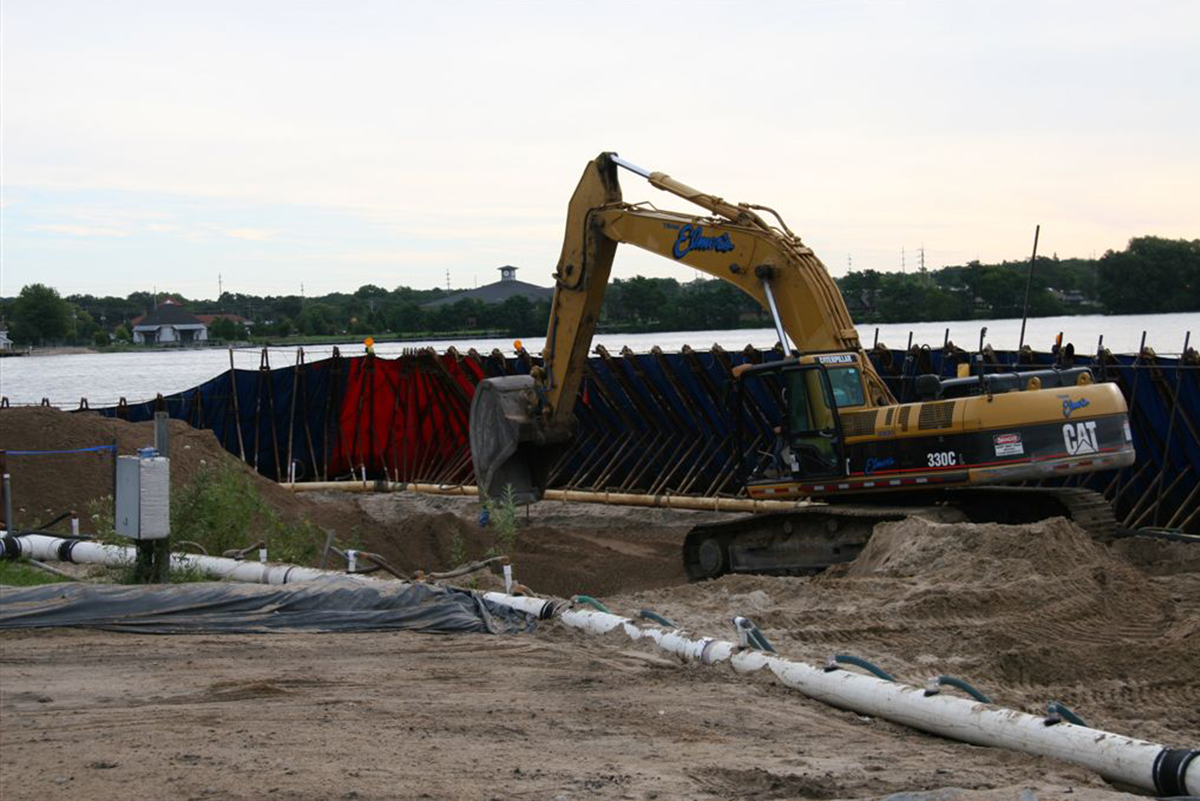

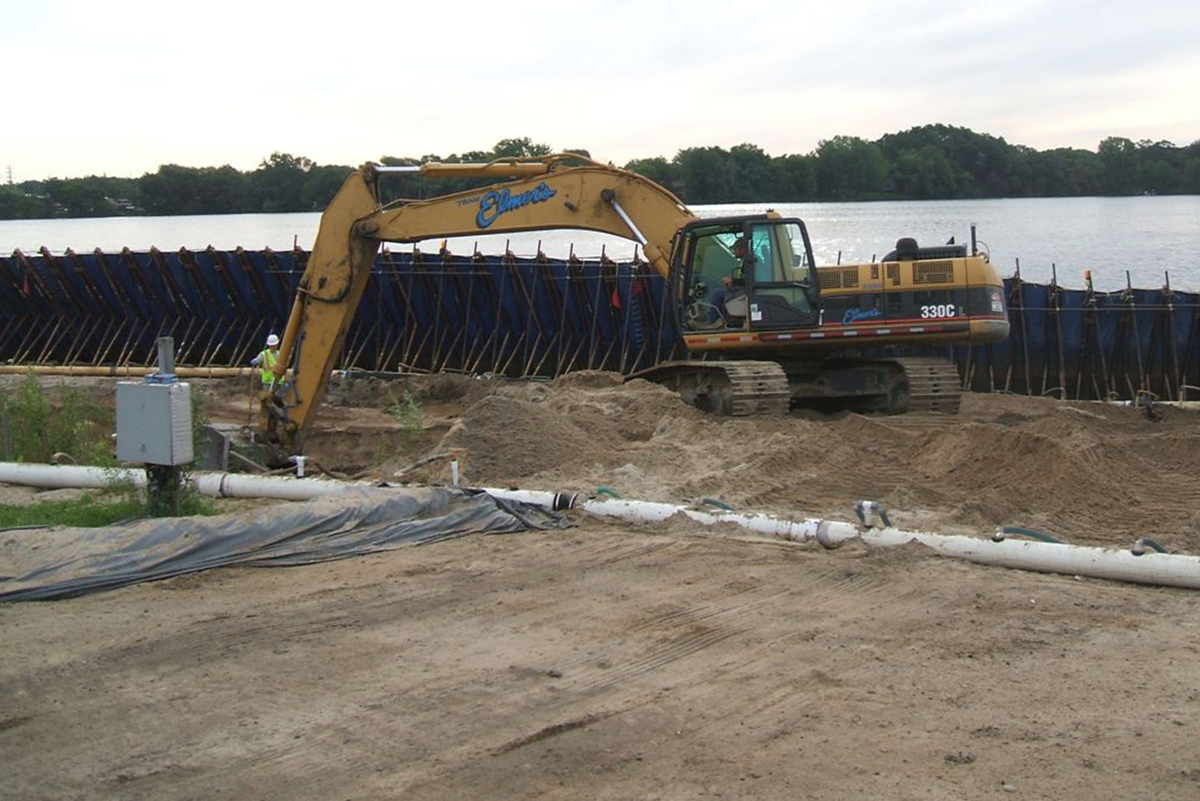

Once the dam was in place, water was pumped from inside the dam, discharged into the lake, and 260 dewatering points were installed up to 16 feet deep. The contaminated water was then pumped through a two-stage carbon system to remove contaminants. The crews obtained a permit to allow them to discharge clean filtered water into Boardman Lake.

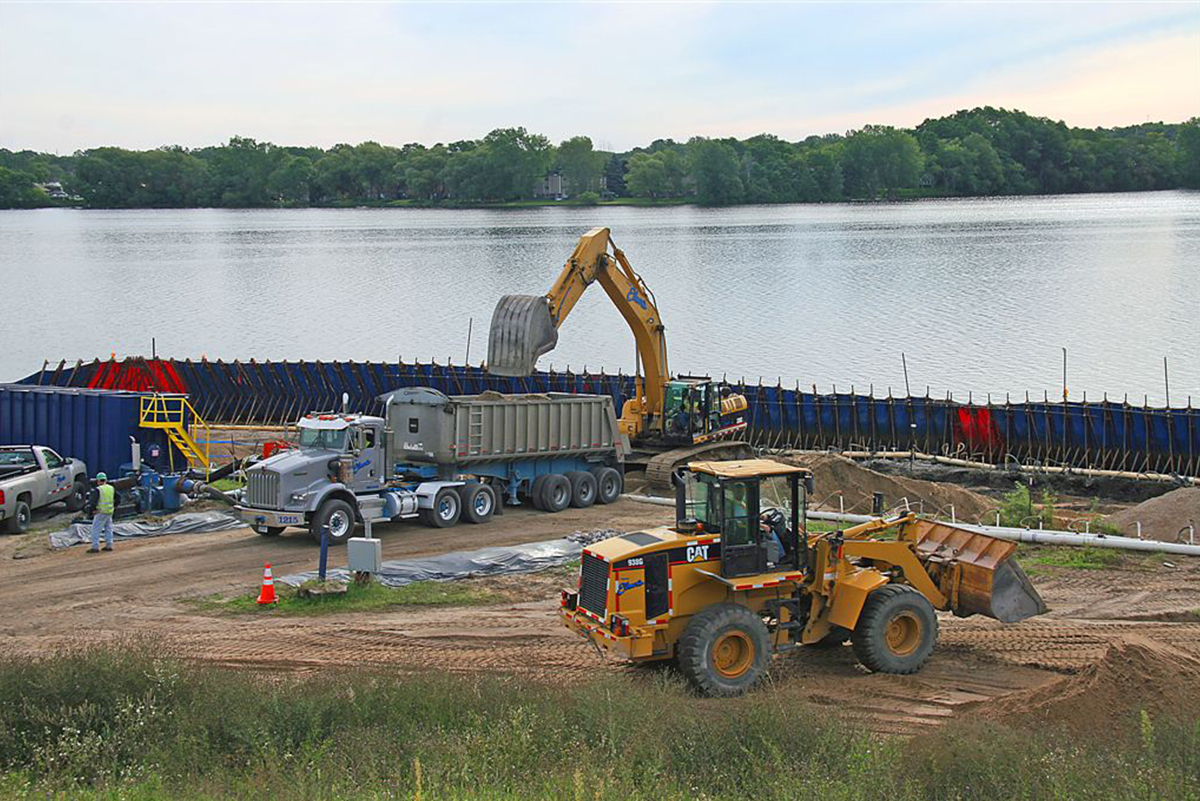

Next, inspectors from the various parties, including DEQ, worked together to determine which soils should be removed. The water table was lowered to 9 feet below the lake bottom to remove all the impacted soils. All told, Team Elmer’s excavated and removed 2,210 tons of contaminated soil from the bottom of the lake.
Clean soil was then placed in the lake and compacted/ backfilled, the water was replaced, and the dam was dismantled by divers with the support of Team Elmer’s crews on shore.
The project was a source of pride for Team Elmer’s staff, a job well done for GRT, and a sustainable victory for Boardman Lake and the community!
“We selected Team Elmer's because they approached this project in a way that other contractors hadn't considered,” said Adam Segerlind, PE of Global Remediation Technologies. “Their innovative strategy of implementing a temporary dam and dewatering system was cost-effective and their local ties meant they were more suited to overcome the inevitable hiccups that happen along the way. My expectations were met and exceeded!”
CONTACT: Adam Segerlind (231) 941-8622
SELF PERFORMED: 95%
PARTNERS: Department of Environmental Quality (DEQ)
